Agile Project Management for Software Projects: Sprint Planning, Reviews and Retrospectives

Grzegorz Hajdukiewicz
|   Updated Nov 22, 2026

Agile project management runs a software project in short, fixed-length cycles called sprints. Each sprint ends with working software the client can review and a retrospective where the team decides what to change.

The point is to put every assumption about scope, budget and users in front of real evidence every week or two, instead of finding out at launch.

This guide covers when agile fits a project and when it doesn't, who you need on the team, how to plan and scope sprints, and how to run retrospectives that change how the team works.

Executive Summary

Agile project management swaps one big plan made at the start for many small plans, each checked against working software.

It pays off when requirements are uncertain and the client can stay involved. It's a poor fit for very short projects, frozen specifications and budgets with no room to move scope.

Three practices decide whether it works: a client acting as Product Owner, sprint planning based on what the budget can buy rather than on padded estimates, and retrospectives that end with one or two owned action items.

Without those three, agile turns into a series of meetings with a waterfall project underneath.

What Is Agile Project Management and How Is It Different From Waterfall?

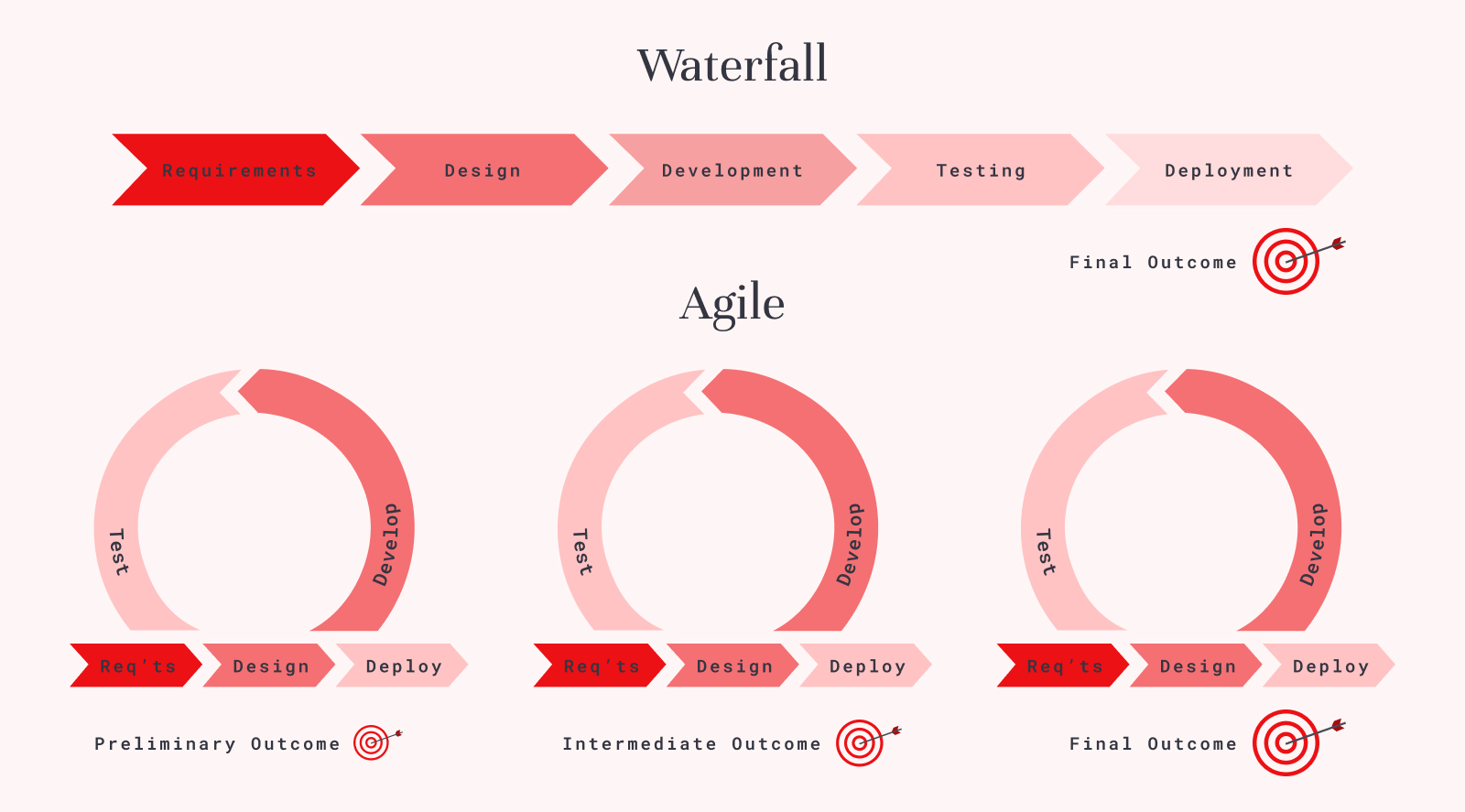

Agile project management is an iterative way of building software in which planning, building, testing and feedback happen in every cycle, not once per project. It follows the values of the Manifesto for Agile Software Development, written in 2001 by 17 software practitioners.

Waterfall runs the same activities in sequence: specify everything, design, build, test, then launch. That works when nothing changes along the way. In software, something almost always changes: users react differently than expected, a third-party API behaves differently than its docs say, or a competitor ships first. In a waterfall project, the client first sees the product when it's nearly finished, which is the most expensive moment to learn it's wrong.

Agile relies on three habits: transparency (everyone works from the same real data), inspection (the team checks progress and the product at fixed points) and adaptation (the plan changes when the evidence says it should). Scrum, the most widely used agile framework, builds these into a fixed set of events. Kanban, the other common option, drops sprints in favor of a continuous flow with limits on work in progress. Many teams combine the two.

When Is Agile Project Management the Wrong Choice for a Software Project?

Agile is the wrong choice when the project is too short to iterate, the scope can't change, or nobody on the client side has time to make decisions every week. Here's how the main factors compare:

Factor

Agile fits

Waterfall or hybrid fits

Requirements

Uncertain, expected to change after user feedback

Fixed and fully known up front

Regulation

Light, or compliance work can be planned into sprints

Strict sign-offs on a fixed specification, as in some medical or automotive projects

Timeline

Longer than about two months, e.g. MVP development or a new product line

A few weeks, too short to split into meaningful sprints

Budget

Fixed budget with flexible scope, or a flexible budget

Fixed budget and fixed scope

Client availability

Someone can act as Product Owner and attend reviews

The client wants to see results only at the end

The last row is easy to underestimate. Agile asks the client to make product decisions, answer questions within a day or two, and show up at sprint reviews. If that isn't possible, a hybrid approach, with a detailed discovery phase followed by iterative delivery, is usually the more honest choice.

What Roles Does an Agile Software Project Need?

An agile software project needs a Product Owner who decides what gets built, a Scrum Master or agile project manager who keeps the process working, and a cross-functional team of developers. The 2020 Scrum Guide defines exactly these three accountabilities: Product Owner, Scrum Master and Developers. In Scrum, "Developers" covers everyone who builds the product, including QA engineers and designers.

When you work with an external development partner, the Product Owner is usually you, the client. You own the product backlog, set priorities and accept or reject finished work. A business analyst on the partner's side can help turn your goals into backlog items, but the decisions stay with you.

Plan for that time. Joanna Kostana, a project manager at Monterail, warns clients to get ready for daily updates and near-constant contact with the team, and to expect that early estimates won't be fully precise, especially while the scope is still moving.

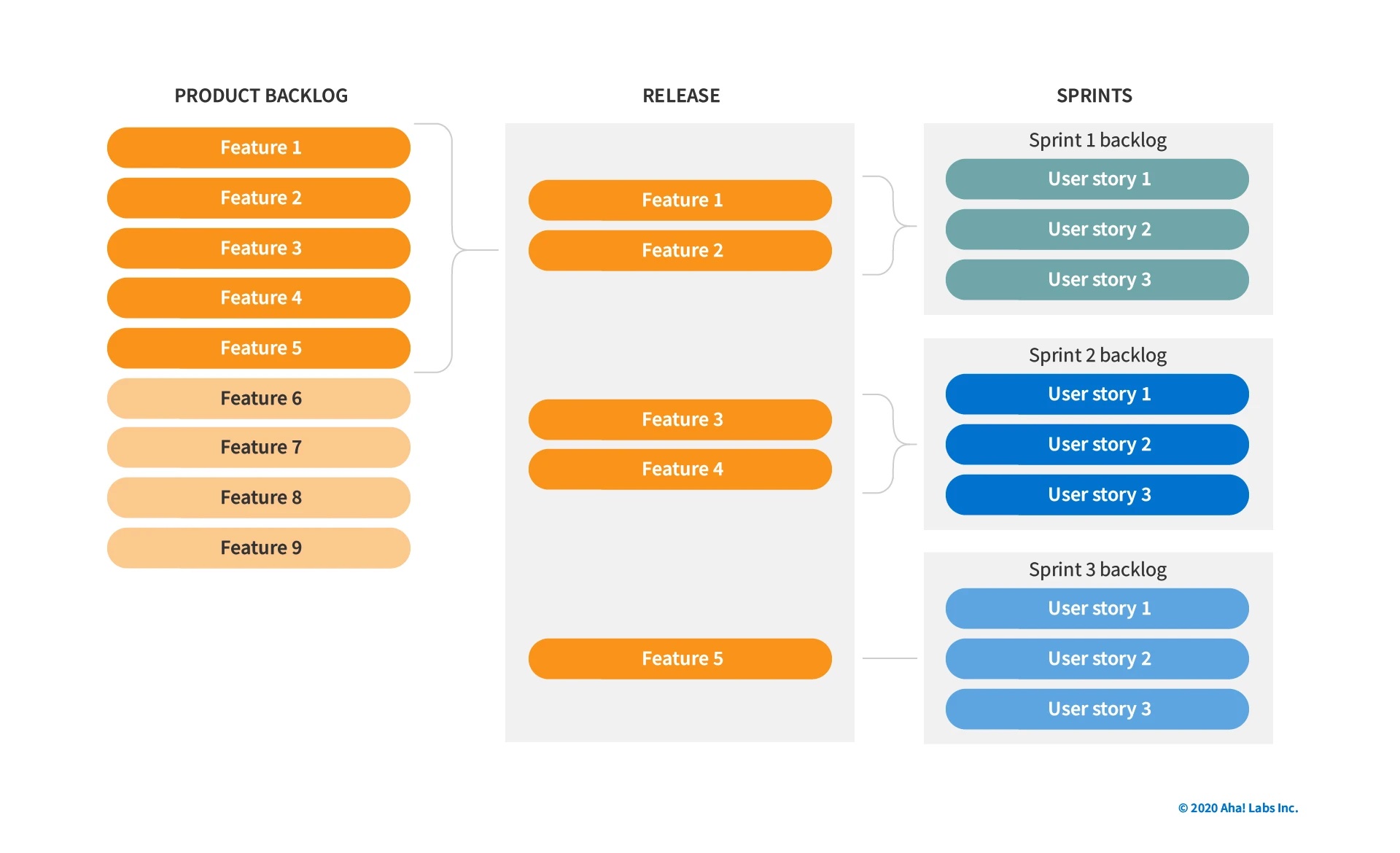

How Does an Agile Sprint Run, From Sprint 0 to Release?

An agile project usually starts with a short setup phase, often called Sprint 0, followed by a series of identical sprints, each lasting one month or less (two weeks is common). Every sprint follows the same rhythm.

Sprint 0 is the project before the project: assemble the team, set up environments and tools, hold the kickoff and write the first backlog. Keep it short. Its job is to make the first real sprint possible, not to produce a full specification.

Sprint planning opens each sprint. The team picks the backlog items it can finish and agrees on a sprint goal. Backlog items work best written as user stories ("As a user, I want to reset my password so that I can get back into my account"), because they state the value, not just the feature. Before planning, the team should agree on a Definition of Ready (what an item needs before work starts) and a Definition of Done (what "finished" means, including tests and review). Expect to refine both after the first few sprints.

Every day, the Developers hold a 15-minute Daily Scrum to check progress toward the sprint goal and plan the next day. The Scrum Guide no longer prescribes the classic three questions, so use whatever format keeps it short and useful.

Split work so it delivers value early. Take a sign-up form with name, address and photo upload. If the team builds the whole frontend and then the whole backend, the form does nothing until both are finished. If it builds the form field by field, end to end, each finished field works and can be tested.

The sprint review closes the sprint: the team shows the client what it built, and the backlog gets adjusted based on what everyone learned. Schedule it from the very first sprint. There's always something to show, even if it's only the environments and the first working screen.

The retrospective follows the review and is for the team itself (see below).

Release doesn't have to wait for the last sprint. With continuous delivery, finished work can go to production or a test environment every sprint, so the client can use the product from early on and there's no high-risk launch at the end.

How Should You Estimate and Scope Sprint Planning?

The most reliable way to scope a sprint is to decide first what you can spend, in time or money, and then fit the scope to that budget. Feature-by-feature estimates are useful inputs, but they are poor promises. The three common approaches compare like this:

Method

How it works

Where it breaks

Time estimates

Developers estimate each task in hours

Guesses become commitments; dependencies in Gantt-style plans fail together

Story points and velocity

Tasks get relative difficulty points; velocity tracks points per sprint

Points mean nothing to stakeholders; velocity is unstable after any team change

Fixed-budget (reverse) scoping

Fix the time or money for a goal, then cut or expand scope to fit

Needs a Product Owner willing to cut features

Time estimates are absolute and easy to understand, but they rest on one person's guess. They hold up for routine, repeated tasks and fall apart for anything new.

Story points measure difficulty relative to other items, and velocity (points completed per sprint) adjusts automatically as the team changes. That's an improvement, but points are specific to one team and hard to explain to a budget owner. Burndown charts built on them can also drift toward what their authors hope to see, and any change to the team unsettles velocity for several sprints.

Fixed-budget scoping, which Kamil Nicieja described on this blog as reverse scoping, flips the order. You choose a backlog item, decide up front how much time or money it's worth, and let the team cut or expand scope to fit. Business stakeholders understand budgets far better than story points, and the conversation changes: "Expanding the scope will take us over budget" is a much easier sentence to accept than "the estimate was wrong."

Whatever method you use, check budget against delivered value every sprint, and drop nice-to-haves early rather than late.

What Is an Agile Retrospective and Why Does It Matter?

An agile retrospective is a meeting at the end of each sprint where the team looks at how it worked, not at what it built, and agrees on concrete improvements for the next sprint. The Scrum Guide caps it at three hours for a one-month sprint; for a two-week sprint, an hour is usually enough.

Busy teams are tempted to skip it. One Monterail team spent part of every week for a month and a half fixing the same recurring issue, close to 20 hours in total, before anyone noticed the pattern. A single retrospective conversation would have caught it in week one.

The Agile Manifesto makes this a principle: at regular intervals, the team reflects on how to become more effective, then adjusts its behavior. Retrospectives are also where a team owns its process. It agrees on a change together and is responsible for the result, which matters most in new teams that are still learning to work together.

The retrospective is different from the sprint review. The review inspects the product with the client. The retrospective inspects the way of working, usually without the client in the room.

How Do You Run an Agile Retrospective That Changes Something?

A useful retrospective ends with one to three specific action items, each with an owner, that the team checks at the next retrospective. Everything else in the meeting serves that outcome.

What works in practice:

  • Prepare. The facilitator (usually the Scrum Master or project manager) brings an agenda and an exercise. Retromat has a large library of activities, and rotating them keeps long-running teams from going through the motions.

  • Make it safe to speak. People raise real problems only when nothing said in the room leaks out or gets used against them. Give quieter team members a written option, such as sticky notes.

  • Discuss actions, not people. Ask what went wrong in the process and how to prevent it, not who caused it.

  • Write actions that can be checked. "Set up a weekly call with the client's IT team" can be checked. "Communicate better" can't.

  • Start with last time's actions. Opening with a review of the previous action items is what turns separate meetings into continuous improvement.

What to avoid: letting the meeting turn into a complaint session with no proposed fix, committing to more changes than the team can make in one sprint, and skipping retrospectives when the schedule gets tight. That's exactly when they're needed most.

How Do You Keep the Client and the Budget on Track in an Agile Project?

You keep an agile project on track by making budget, progress and problems visible every sprint, so there are no surprises to manage later. Four habits matter most:

  • Review budget against value at every sprint planning. Check what the remaining budget can deliver and cut scope before it's spent, not after.

  • Use the sprint review as the main status update. It shows real software instead of a status report, and it reminds everyone that each sprint should deliver something of value.

  • Report problems as soon as you know about them. When something goes wrong, even through the team's own mistake, the client has a right to know and a say in how to fix it. Hiding it costs more trust than the problem itself.

  • Let the client and developers talk directly. A project manager who acts as the only channel slows every answer down. Step in only when the conversations start pulling the team away from the sprint goal.

Small practical choices help too: avoid starting sprints on a Monday, when calendars are fullest, and keep backlog detail for the next few sprints only, since anything planned further ahead will change.

Key Takeaways

  • Agile fits projects with uncertain requirements and a client who can make decisions every week.

  • A fixed budget with fixed scope is a waterfall project, whatever the process is called.

  • Fit scope to budget each sprint rather than turning estimates into promises.

  • Schedule the sprint review from the first sprint; there's always something to show.

  • A retrospective is only useful if it ends with one to three owned, checkable actions.

What Does It Take to Make Agile Project Management Work?

Agile project management works when the client treats it as a way of making decisions, not a reporting format. That means a Product Owner with time for the role, scope that moves when the evidence changes, budgets checked every sprint, and retrospectives that produce changes someone owns. Drop any of these and the process stays on paper while the project behaves like waterfall.

Monterail has delivered more than 900 projects for clients from first-time founders to enterprises, and agile is our primary way of running them. If you're planning a product and want to know whether agile suits it, or how a sprint-based engagement would work with your budget, get in touch and we'll talk it through.
